MAKLUMAT LAPORAN KHIDMAT BANTU ICT PTIS BAU


NO. ID LAPORAN: PTISB/LOG/341
Tarikh & Masa 15-04-2026 HINGGA 17-04-2026 (09:00)
Nama Sekolah SMK PAKU - YEA1101
Kaedah Pelaksanaan Kunjungan Tapak
Tugasan Yang Dilaksana PEMASANGAN DAN PENYAMBUNGAN FIBER OPTIC DI BAWAH PROJEK "FIXED BROADBAND FIBER OPTIC INFRASTRUCTURE NON-STANDART INSTALLATION (NSI) AT THE INDENTIFIED SCHOOLS UNDER THE POINT OF PRESENCE (POP) PROJECT.
JTK Bertugas
  • HERMALINA BINTI RAINI
  • HEYWOOD ANAK JEHIA
  • NUR AYUNI BINTI ISMAIL
  • NUR SHAFINA BINTI MOHAMED RAFEEK
Penemuan / Masalah 1. KENALPASTI PEMASANGAN DAN PENYAMBUNGAN FIBER OPTIK KEBERADAAN POLE DI TAPAK SEKOLAH DAN KEDUDUKAN FTB1,FTB2 DAN FTB3.
2. MENANDAKAN LOKASI FDP (FIBER DISTRIBUTION POINT) DAN FWS (FIBER WALL SOCKET) YANG DICADANGKAN.
3. MENGETAHUI JARAK DARI FDP POP YANG DIBERIKAN 25 METER .
4. PEMASANGAN TRUNKING KABEL BAHARU.
5. PEMASANGAN PENARIKAN KABEL

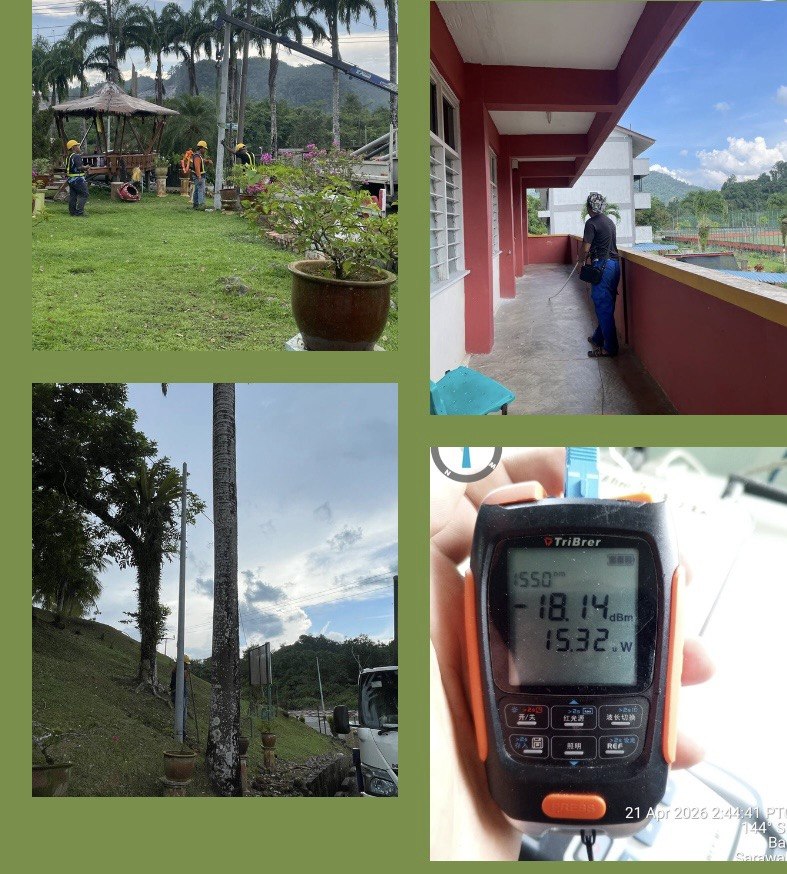

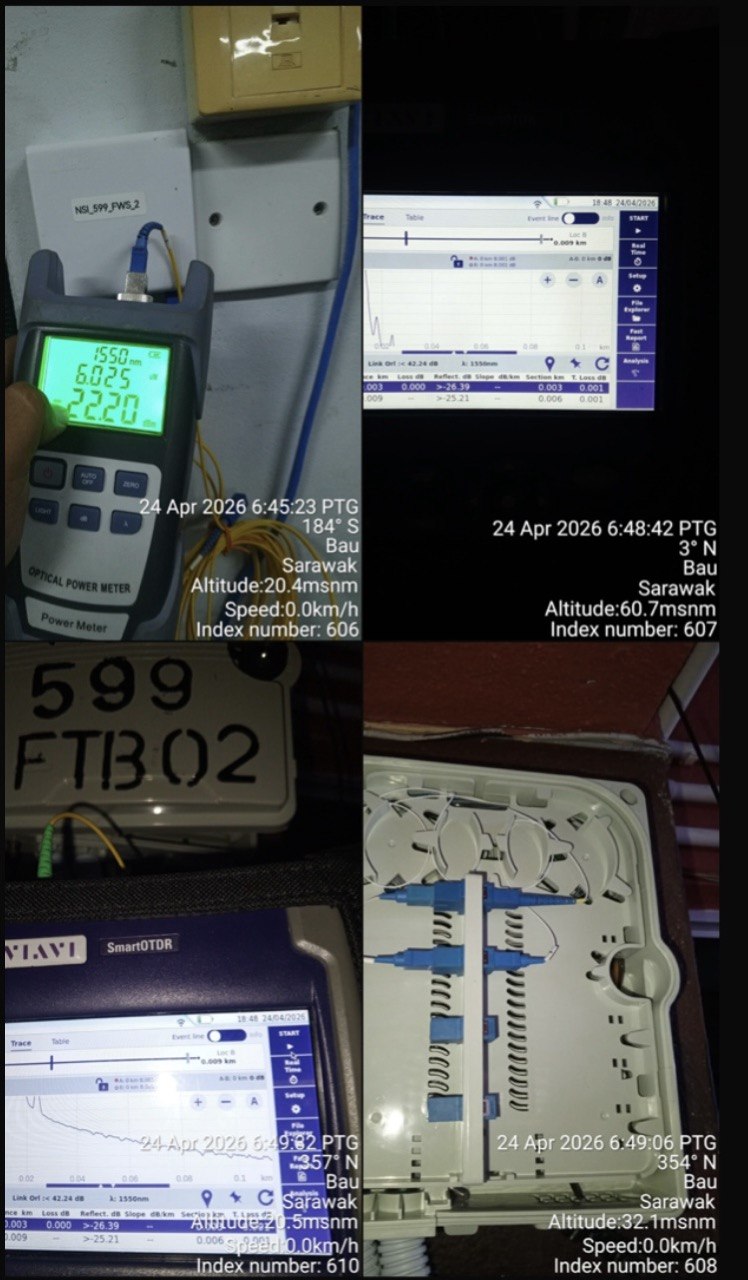

6. UJI KELAJUAN INTERNET MENEPATI SPESIFIKASI .

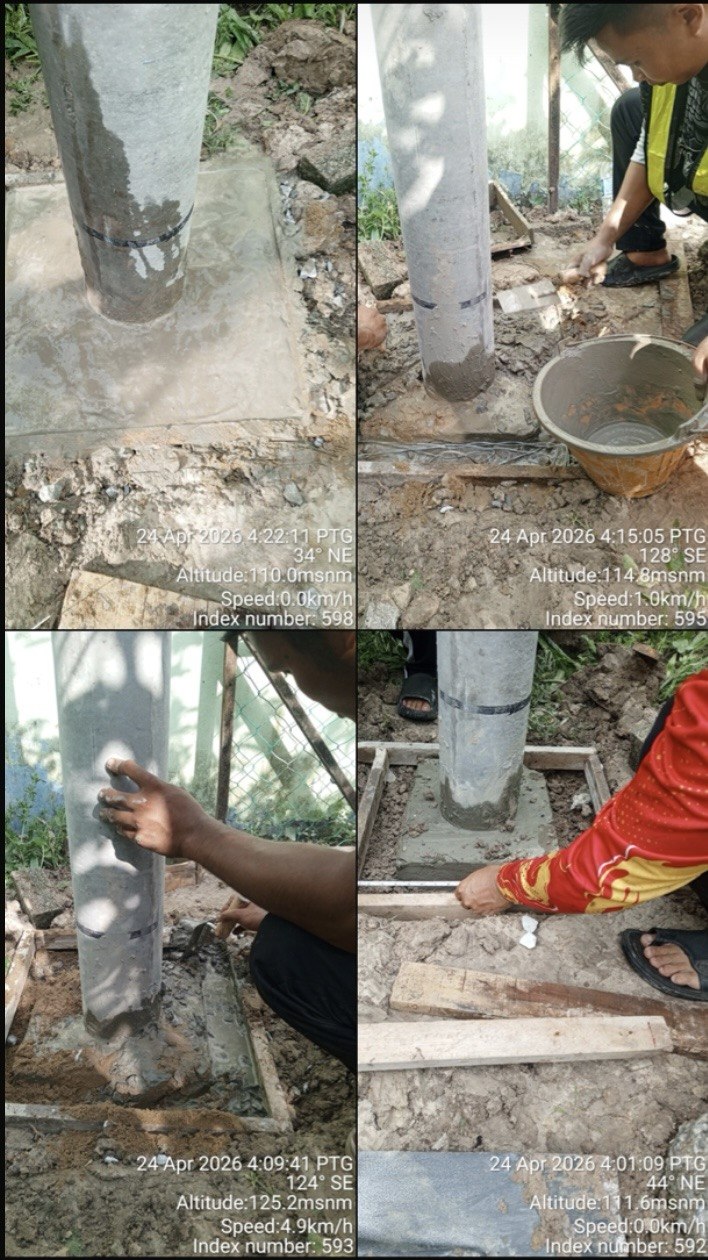

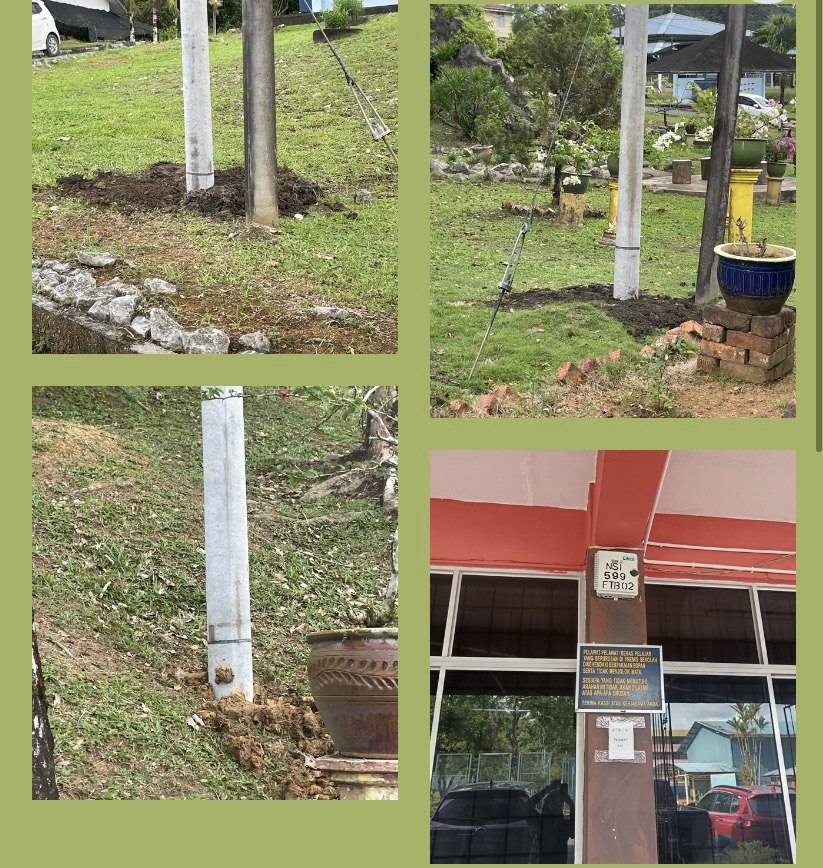

Tindakan / Penyelesaian 1.KAEDAH PEMASANGAN MENGGUNAKAN TIANG (POLE) 4 BATANG..
2.PEMASANGAN TEKNIKAL SEPERTI PEMASANGAN TRUNKING KABEL BAHARU DAN BEBERAPA SEGMEN LALUAN KABEL UTAMA SEPERTI,
-LALUAN KABEL DARI NCP2 KE NCP3 DAN NCP3 KE NCP4.
-LALUAN KABEL DARI NCP4 KE FTB1.
-LALUAN KABEL AGIHAN (DROP FIBRE) FWS1 DAN FWS 2 DARI TB.

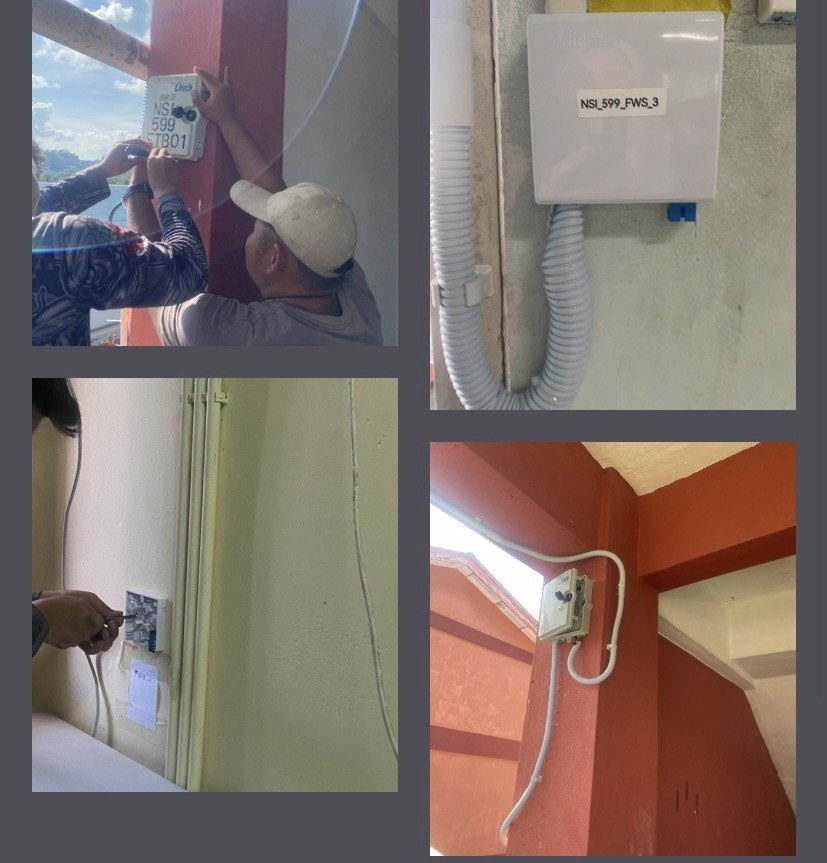

3.PEMASANGAN TELAH SIAP DIPASANG IAITU FTB1 DILETAKKAN AREA TANGGA TINGKAT 3,PUSAT SUMBER. BOX FWS DALAM PUSAT SUMBER,RUANGAN ICT.
FTB2 PULA, DILETAKKAN LUAR PEJABAT AM. BOX FWS DI DA
Status Selesai
Gambar Laporan
Gambar Laporan
Gambar Laporan
Gambar Laporan
Gambar Laporan
Gambar Laporan
Gambar Laporan

HERMALINA BINTI RAINI
JURUTEKNIK KOMPUTER - FT1
PASUKAN TEKNIKAL ICT SEKOLAH (PTIS), PPD BAU
29-04-2026
